Using an Agile Software Process with Offshore Development

Relia Software

Relia Software

Offshore agile software development means implementing iterative, sprint-based work cycles with an overseas engineering team to build software products.

Agile Offshore Software Development: A Complete Guide

Agile relies on fast feedback, frequent communication, and close collaboration. Meanwhile, offshore software development involves remote teams working thousands of miles apart, sharing only a few working hours, and depending on written communication.

The contrast between Agile and offshore development doesn't mean they are incompatible. Instead, the Agile process needs to be adapted for a distributed environment.

This guide explains how to implement Agile in offshore software development, from preparing the team and structuring sprints to managing time-zone differences, engineering practices, tools, and performance metrics.

What is Offshore Agile Software Development?

Offshore agile software development is the practice of implementing iterative, sprint-based delivery using Agile frameworks (e.g., Scrum, Kanban) with an engineering team located in a different country and time zone.

The Agile offshore model differs from both traditional offshore software development and standard Agile practices.

Compared with traditional offshore development: not every offshore engagement is agile. A fixed-scope, fixed-price contract with quarterly deliverables is offshore development without agile practices, since it has no sprints, no recurring ceremonies, and no iterative feedback loop with the client.

Compared with standard Agile practices: the same ceremonies, including standups, sprint planning, reviews, and retrospectives, still apply. However, offshore teams cannot rely on face-to-face communication, which the Agile Manifesto states as the most efficient way to convey information within a team, as co-located teams. The main changes are therefore the timing, format, and channels running these ceremonies.

Using an agile software process with offshore development
Using an agile software process with offshore development.

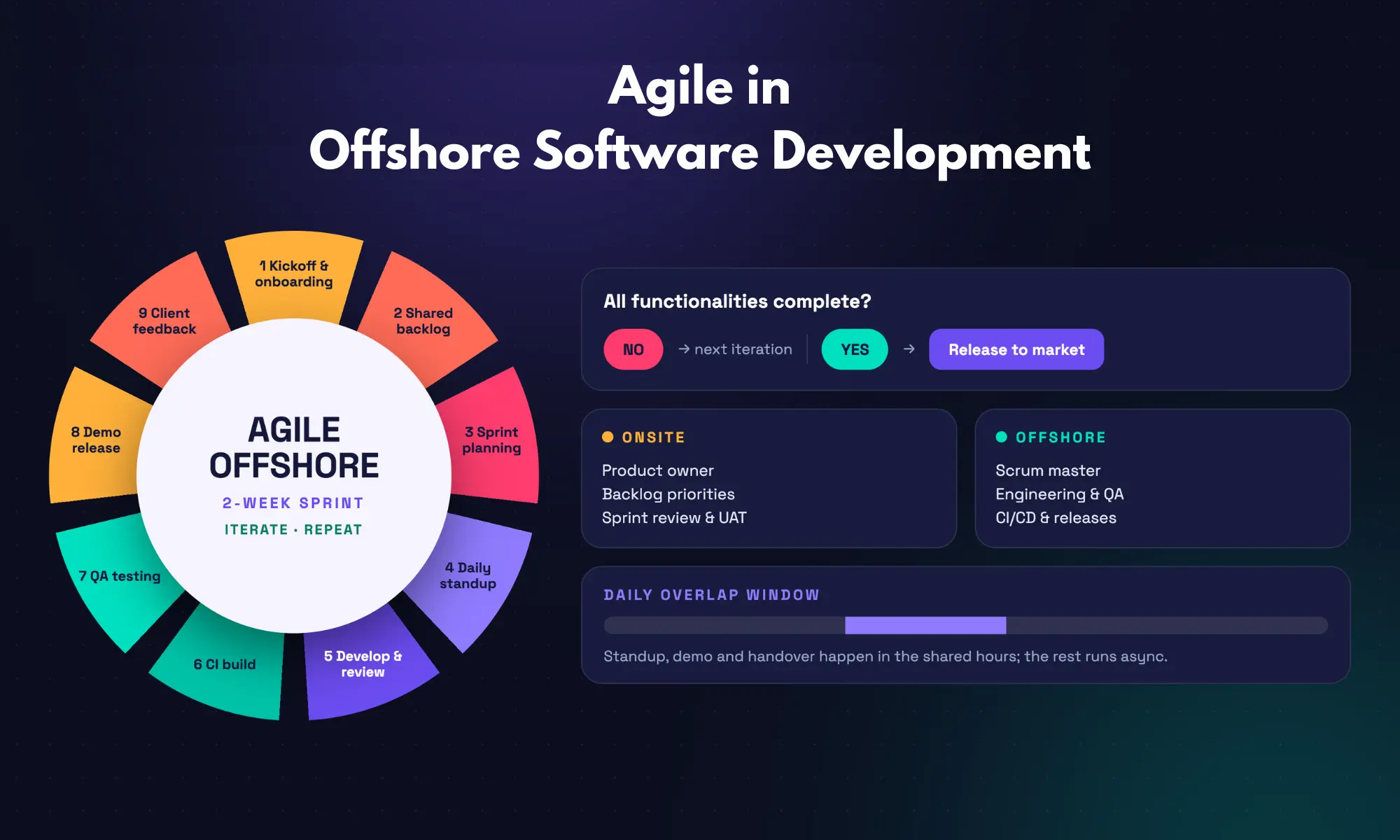

How to Implement Agile in Offshore Software Development?

Adopting agile processes in offshore software development follows six steps:

Step 1: Choose the Engagement Model

The engagement model determines how deeply the offshore team integrates into the company's own Agile process, so it should be decided first..

  • A dedicated team works long term within your sprint cadence, backlog, and ceremonies, much like an in-house team.
  • Staff augmentation adds individual engineers into an existing in-house team, your internal leads keep control of the process and technical direction.
  • A project-based contract scopes a defined deliverable with its own milestones, and the provider manages delivery against that scope.

Agile fits a dedicated team or staff augmentation model best, because both support ongoing participation in the same backlog, sprints, and ceremonies, not a fixed handoff at the end of a contract. Project-based outsourcing can still use Agile internally, but the client usually works through milestone reviews rather than joining one shared Agile process.

Step 2: Select the Overlap Model and Location

Match the overlap model to how real-time the work needs to be. Three overlap patterns cover most offshore agile engagements.

Overlap Model

Typical Overlap

Best Fit

Tradeoff

Half-day overlap

Several hours of shared working time

Most dedicated-team engagements; enough time for standups, pairing, and quick questions

Requires one side to shift working hours somewhat

Full onshore-hours shift

Offshore team works a shift matching onshore hours

Support coverage, incident response, or continuous delivery needs

Offshore team works outside its own local daytime, which affects retention over time

Async-first

Little to no live overlap

Well-documented, loosely coupled workstreams with a mature offshore team

Requires strong written documentation discipline; not a fit for early-stage or unclear requirements

A team supporting active feature development with frequent client input needs enough live overlap for daily standups and pairing. A team maintaining a stable, well-documented service can often run async-first with far less live overlap.

Location follows from that overlap model decision. Choose the team location based on the required working-hour overlap, not just the lowest hourly rate. A cheaper team with limited real-time overlap can delay decisions, leading to missed sprint goals and rework that cost more than initial cost savings.

Also compare the location’s public holiday calendar with the company’s own, as overlapping holidays can reduce the available working-hour overlap during a sprint.

Step 3: Define Product and Technical Ownership

Set decision ownership before the offshore team starts working. Name:

  • the Product Owner who controls backlog priorities and accepts completed work,
  • the in-house technical lead who owns architecture and coding standards,
  • the offshore team lead who handles day-to-day delivery.

Also define backup decision-makers and escalation paths for product, architecture, infrastructure, and security issues. Thus, the offshore team avoids losing a full working day whenever the primary owner is offline.

Step 4: Centralize Tools and Prepare the Shared Backlog

Standardize on one project board, such as Jira or Linear, one video conferencing tool, and one shared documentation source. Also, use GitHub or GitLab for code collaboration and automated CI/CD pipelines. Both onshore and offshore teams work from the same backlog, repository, and project information.

Before the first sprint, refine the highest-priority backlog items with enough context for the offshore team to work independently. Each story should include:

  • the expected outcome,
  • acceptance criteria,
  • dependencies,
  • designs where needed,
  • a clear decision owner.

Also agree on a shared Definition of Ready and Definition of Done. Then break only the highest-priority work into sprint-sized stories for the first one or two sprints rather than assigning the entire backlog upfront.

Step 5: Adapt Agile Ceremonies to Time Zones

Fix the exact time for standup, planning, review, and retrospective against the chosen overlap window. Then write the schedule down in a shared team charter or onboarding document.

Each of the four core Scrum ceremonies needs a specific adjustment for offshore work. The right adjustment depends on how much the team's working hours overlap:

Daily Standups: Run standups on video during the overlap hours, not just a written status update in a chat channel. For teams with little overlap, replace the live standup with an async written update posted at the start of each local workday. Then, reserve a shorter live sync for blockers that need real-time discussion.

Sprint Planning: Use a two-pass approach. The offshore team reviews stories and drafts a task breakdown asynchronously before the planning session. A shorter live call then confirms scope and resolves open questions. With limited overlap hours, this two-pass method shortens the live meeting, and gives the offshore team time to think through the work carefully instead of reacting to it in real time.

Sprint Reviews and Demos: Record the demo when the full stakeholder group cannot attend live, but keep at least one live session per sprint when possible. A live demo allows direct back-and-forth, which is often where the most useful feedback surfaces.

Retrospectives: Collect written feedback before the live session. Use the live session to discuss the collected feedback and agree on action items, not wasting time just  drawing out the input itself. In some cultural contexts, team members are more comfortable raising concerns in writing than speaking up in front of the group.

For non-overlap hours, define a simple async communication format such as Context → Issue → Action Needed → Owner → Deadline. So, questions can be answered without unnecessary back-and-forth.

Step 6: Run a Structured Onboarding Sequence

Give a new offshore team member a defined four-week ramp instead of putting them straight into full sprint work.

  • Week 1: Complete environment setup, get access to the codebase and tooling, and review existing documentation.
  • Week 2: Pair with an experienced engineer on real sprint work to build context on the codebase's architecture and conventions.
  • Week 3: Handle small, low-risk stories independently with close code review from the pairing partner.
  • Week 4: Join normal sprint planning and take on standard-sized work alongside the rest of the team.

Four weeks is a reasonable starting point, not a fixed rule. Extend the ramp for complex or poorly documented systems, and shorten it when the codebase and development process are already easy to understand.

Step 7: Define and Track Metrics From the First Sprint

Set initial baselines during the first two or three sprints. Track metrics such as:

  • Velocity or sprint predictability
  • Cycle time
  • Defect escape rate
  • Pull-request turnaround
  • Blocker resolution time
  • Decision latency
  • Team retention

Review the numbers with the team during retrospectives, not just keeping them only in management reports. A slow onboarding sprint is normal, but repeated missed commitments, long decision delays, or high turnover over the following quarter can indicate problems with the engagement model, overlap window, ownership, or ceremony setup.

How to Implement Agile in Offshore Software Development?
How to Implement Agile in Offshore Software Development?

Key Benefits of Agile Offshore Software Development

Faster response: Sprint-based delivery breaks work into one- or two-week cycles. So, the backlog can be reprioritized between sprints instead of waiting for a quarterly release to reflect a change in scope.

Continuous client feedback: A sprint review or demo every one to two weeks surfaces a wrong assumption, and it costs just a few days of rework to fix.

Broader talent pool: Hiring outside the local market gives access to specialized skills that are scarce or expensive to hire locally. Otherwise, offshore development benefits lower labor costs in Vietnam or the Asian-Pacific region.

Extended development coverage: A team structured around a full onshore-hours shift or an async-first handoff can keep work moving while the client-side team is offline.

Scalable team size: A dedicated team or staff augmentation engagement can add or reduce engineers between sprints without renegotiating a fixed-scope contract. Team size so tracks actual backlog demand, not fixing with a milestone schedule set months in advance.

Common Problems in Offshore Agile Software Development

Most problems in offshore agile software development trace back to one of five causes:

Documentation gaps: A decision made informally in a co-located hallway conversation needs to be written down for an offshore team to see it. Without a shared documentation habit, offshore engineers work from outdated or incomplete context.

Ceremonies copied unchanged from a co-located setup: Scheduling standups for only one side, or holding planning entirely live with no async preparation, recreates the exact friction offshore agile work needs to avoid.

Unclear technical ownership: Without a named technical lead and clear decision authority, architectural choices can differ across locations and create inconsistent code patterns.

Security and access control gaps: Offshore engineers need access to code, environments, and sometimes sensitive data. Thus, the questions related to role-based access, credential handling, IP protection, and revocation procedures should be answered clearly in the engagement contract and access provisioning process.

Engagement model mismatch: A project-based contract with strict milestones can conflict with Agile's changing priorities and iterative delivery. The engagement model itself must support ongoing collaboration before ceremony changes can work.

Why Relia Software for Agile Offshore Software Development Services?

Relia Software has delivered more than 300 software products for clients across 18+ countries since 2011. Our team of 50+ developers, QA engineers, and designers works across dedicated team, staff augmentation, and project-based engagements.

For offshore software development services using Agile methodology, that stable team matters because consistent sprint cadence, standups, and retrospectives depend on continuity, not a rotating pool of engineers.

Vietnam’s Asia-Pacific time zone also gives Relia workable overlap for both APAC clients working nearshore hours and U.S. and European clients working offshore hour. Combined with clear IP and access terms, structured onboarding, and a defined ceremony process, that overlap helps offshore Agile teams maintain consistent delivery.

Mekari, an Indonesian B2B software company, is one of real offshore agile projects Relia has delivered. Relia Software started with a three-person offshore team on Mekari's Talenta HR platform in 2017 and scaled to seven engineers as the platform's scope grew.

During development, we stayed integrated into Mekari's own sprint cadence. Talenta grew from a few thousand users to more than 10 million by 2020. "Relia Software has a personable communication style that's complemented by a responsible work ethic." - said Kevin Kennedy Kie, Senior Product Owner at Mekari.

FAQs

Can Scrum work with an offshore team?

Yes. The framework itself does not change. What changes is the timing and format of each ceremony, adjusted to the team's overlap window as described above.

How much time zone overlap does an offshore agile team need?

It depends on how real-time the work needs to be. A half-day overlap covers most dedicated-team engagements, while an async-first model works only for well-documented, loosely coupled work with a mature team.

How long does it take to onboard an offshore agile team?

A four-week sequence, covering setup, paired work, small changes, and full sprint participation, is a reasonable default for a mid-complexity codebase. The exact length varies with codebase size and existing documentation quality.

Is offshore agile software development cheaper than onshore?

Generally yes, per engineer hour, since offshore rates in regions such as Asia-Pacific run well below typical U.S. senior engineering rates. But, total engagement cost also depends on team size, seniority mix, and engagement model.

How do you structure the first sprint with a new offshore team?

Keep the first sprint's scope smaller than a mature team's sprint, and focus on small, well-defined bug fixes or low-risk changes rather than new feature work. This lets a new team build context on the codebase while still shipping something real, not treating the first sprint as a dry run with no output.

Move to full-sized stories from the second or third sprint, once the onboarding process is underway and the team has enough context to work more independently.

Conclusion

Offshore agile software development works when a company treats time zone overlap and engagement model as decisions made before the team starts.

Two things matter most: choosing an overlap model that fits the work and setting clear metrics, such as cycle time, defect escape rate, and retention, to assess performance during the first quarter. Get those two decisions right, and the ceremony adjustments in this guide are enough to keep an offshore team running the same agile process as an in-house one.
